Record of Key Dates / Milestones & Lead Times:
9: Dig Foundation Hole & Remove Excess
9—>10-15: Rain Delay & Concrete Work Lead Time
10-15-10-31: Footings Build & Material Deliveries
11-1: Inspection Approved – Footings Prepour11-4: Foundation Foot & Rock Pour12-2: Approx 28 days per Man. recommendation 4 capillary break (to application after concrete set)12-7 to 12-21: All ICF rebarred walls & waterproof soil side / bottom 4′
Holiday: 12-22–>12-27 & 12-30—>1-2

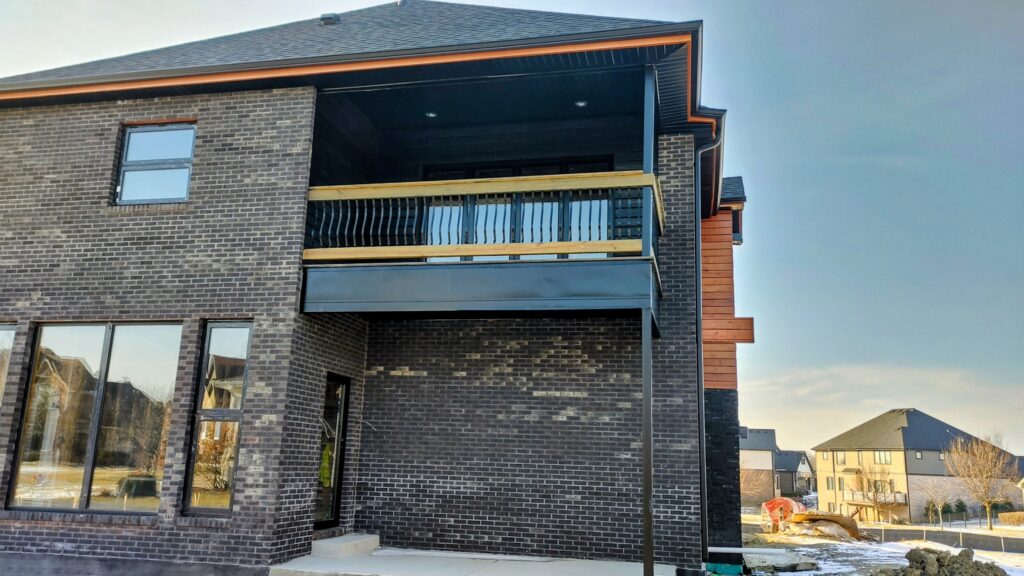

1-5: Radon Installation Part 1, Finalize Porch & Balcony
1-8: Construction Fence & Final Walls Waterproofing
1-9 to 1-31: Weather Stoppage
2-6: Continuous Pour / All Walls
2-8: Capillary Break Top Of Foundation
2-9: Steel Prep / Wood Removal
2-14: Wood Removal Final Concrete
2-19 & 20: Backfill and Excess Dirt Removal
2-22: Steel Set I Beams & Columns (1 Day)
2-27: Start Framing
3-31: 1st Floor & Garage Complete
5-9: Exterior Sheathing & Home Wrap
6-29: 2nd Floor Completion 50%
7-31: 2nd Floor Completion 95%
9-30: Roof & Porch Framing (Guidance)
11-9: Windows In & Roofing On
11-30-12-7: Research & Development

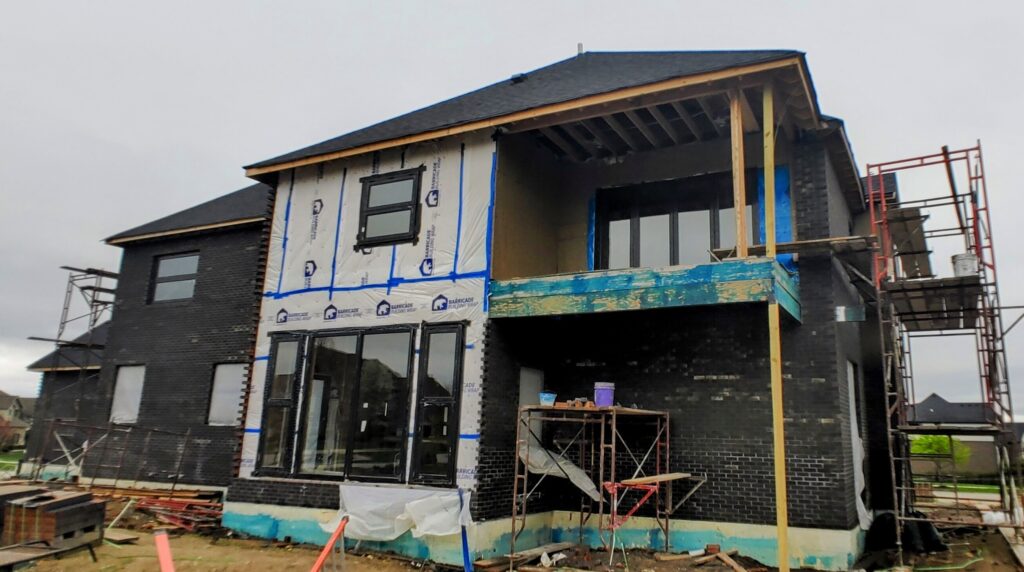

12-16: Start Exterior Cladding (Porch / Fireplace / Balcony)
1-15: Rough In’s Mech’s
3-15: Brick Work
4-20: Brick Work Near Completion
4-25: On Demand Work Stoppage (5 Months)
9-25: Project Restart
9-25 – 12-25: Final Framing Adjustments, Exterior Aluminum (Gutters / Soffiting / Fascia / Porch / Balcony), Window & Door Caulking, HVAC Rough Ins, Final Electrical & Plumbing Rough Ins, Underground Plumbing Service (Water / Sewers), Nicor Gas Service, Comed Service.
1-15: Walls & Ceilings Insulation
1-25: Final PreDrywall Installs (Backers / Shelving Support Systems)

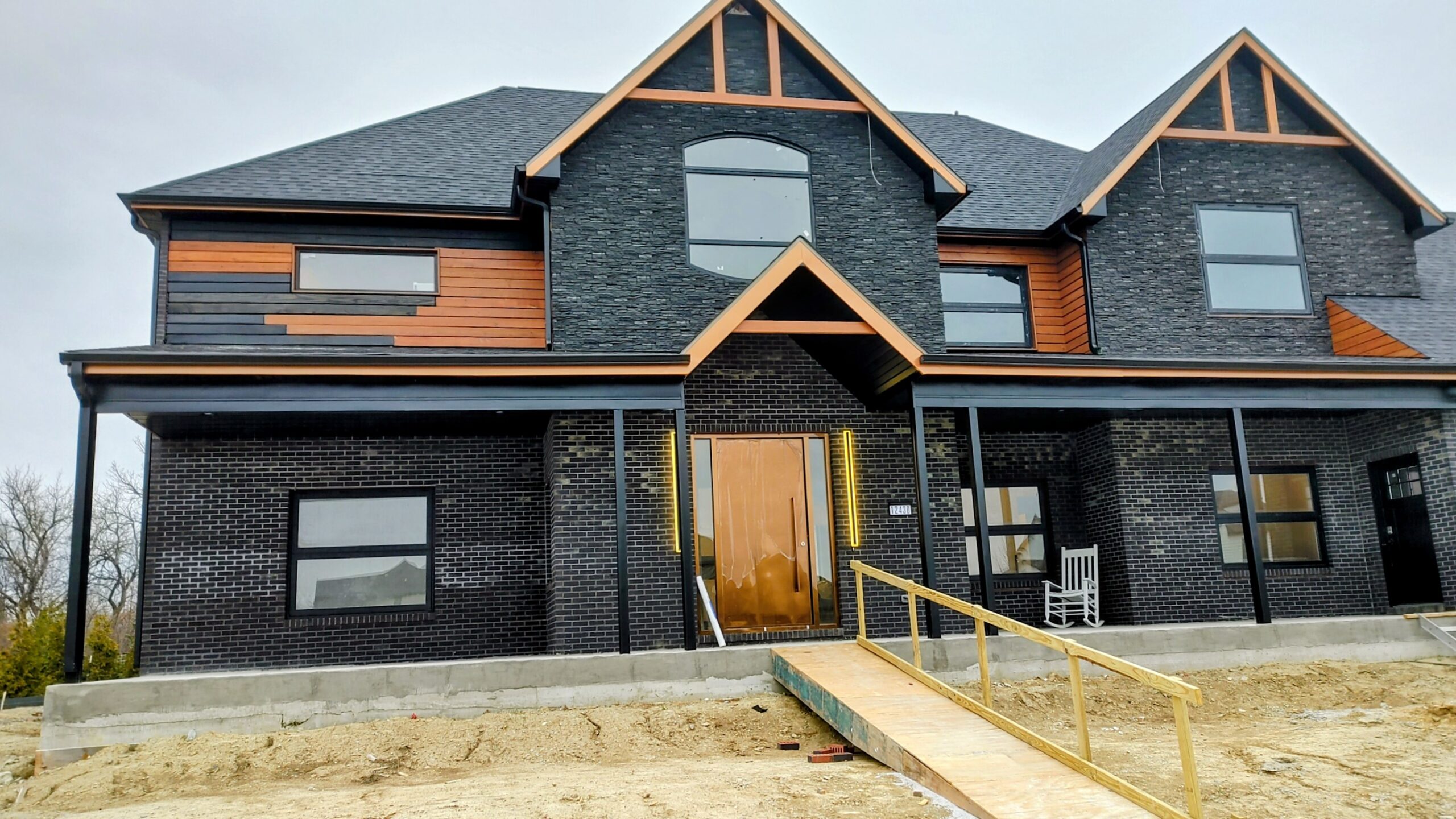

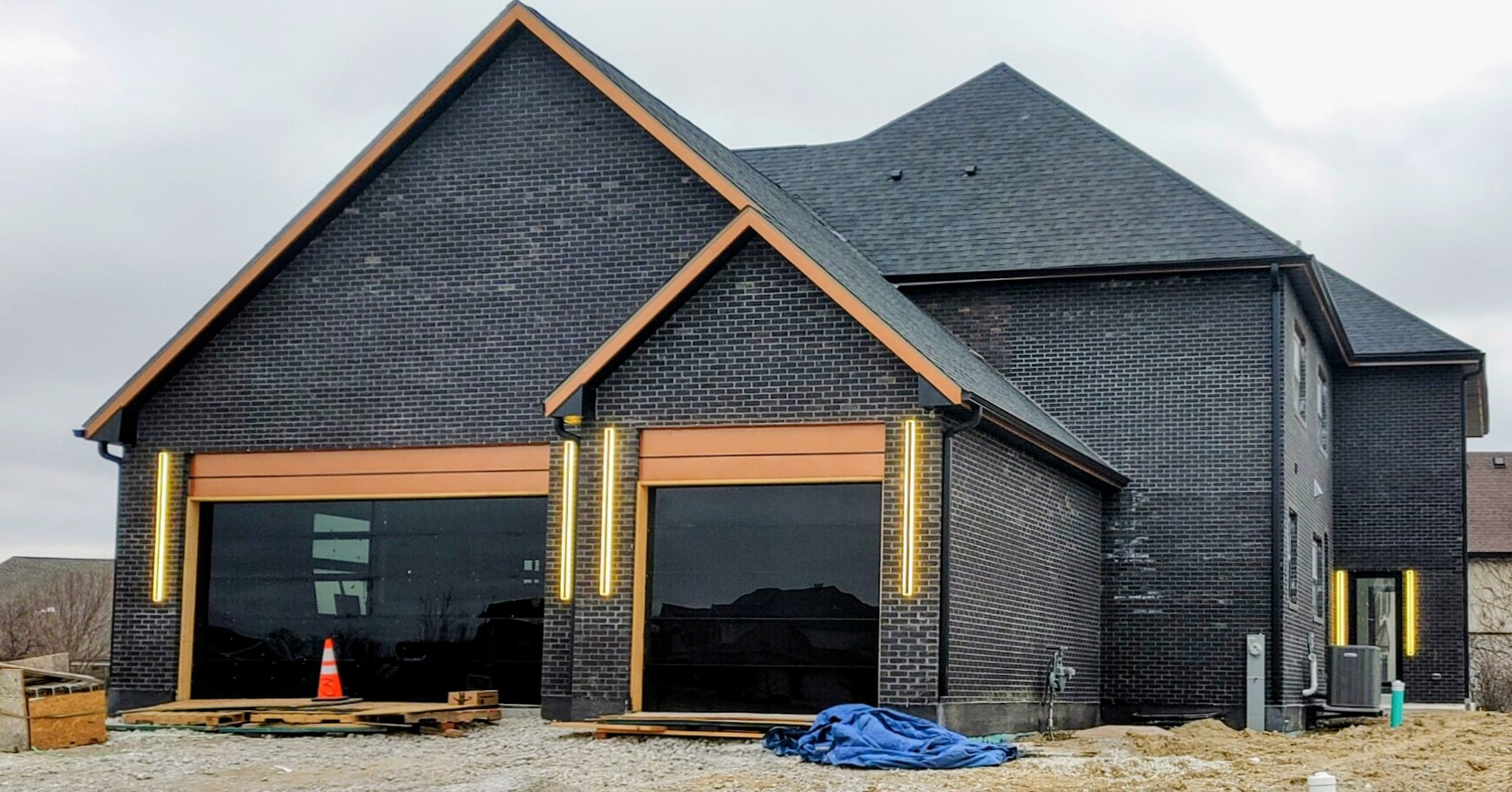

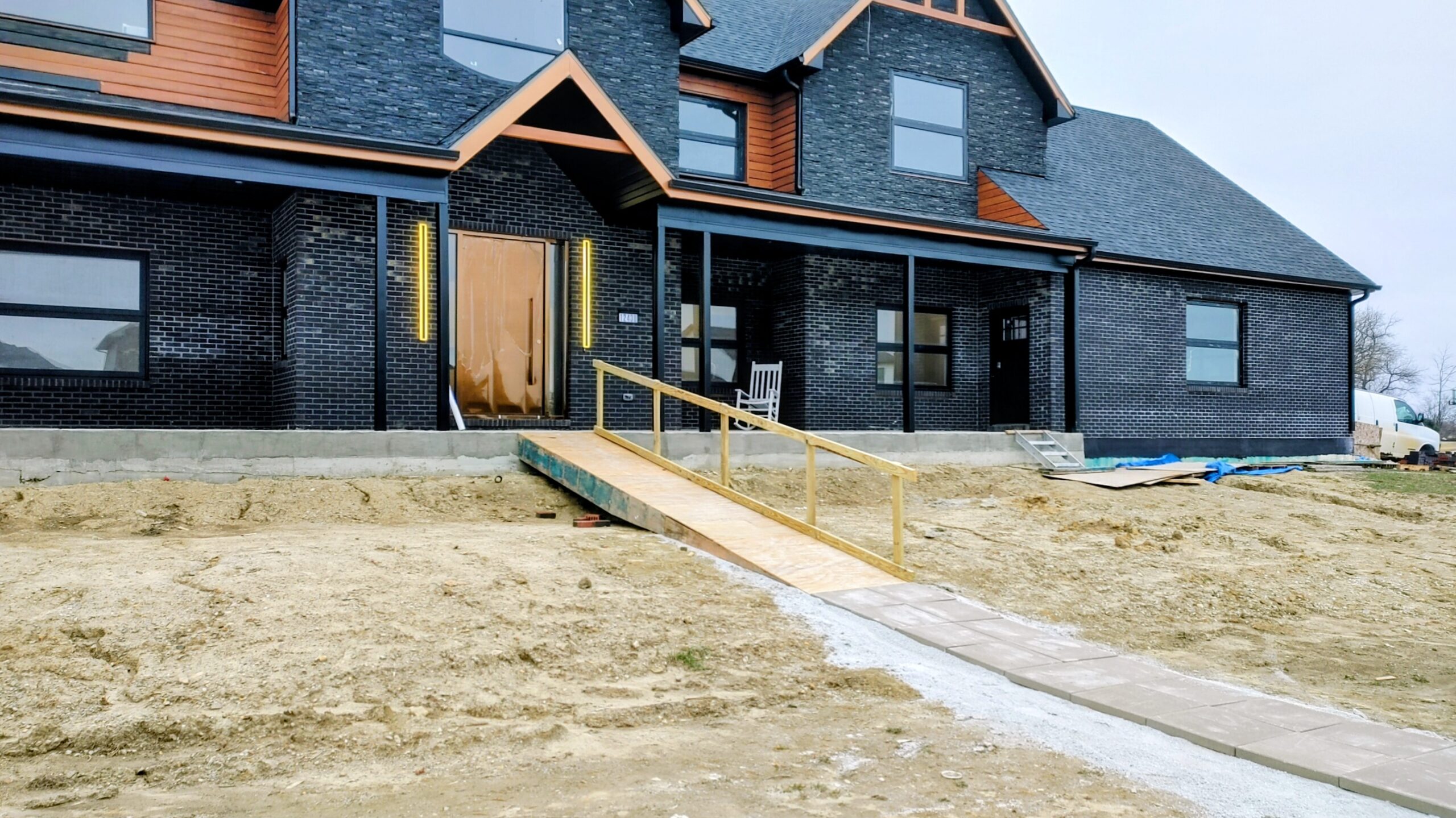

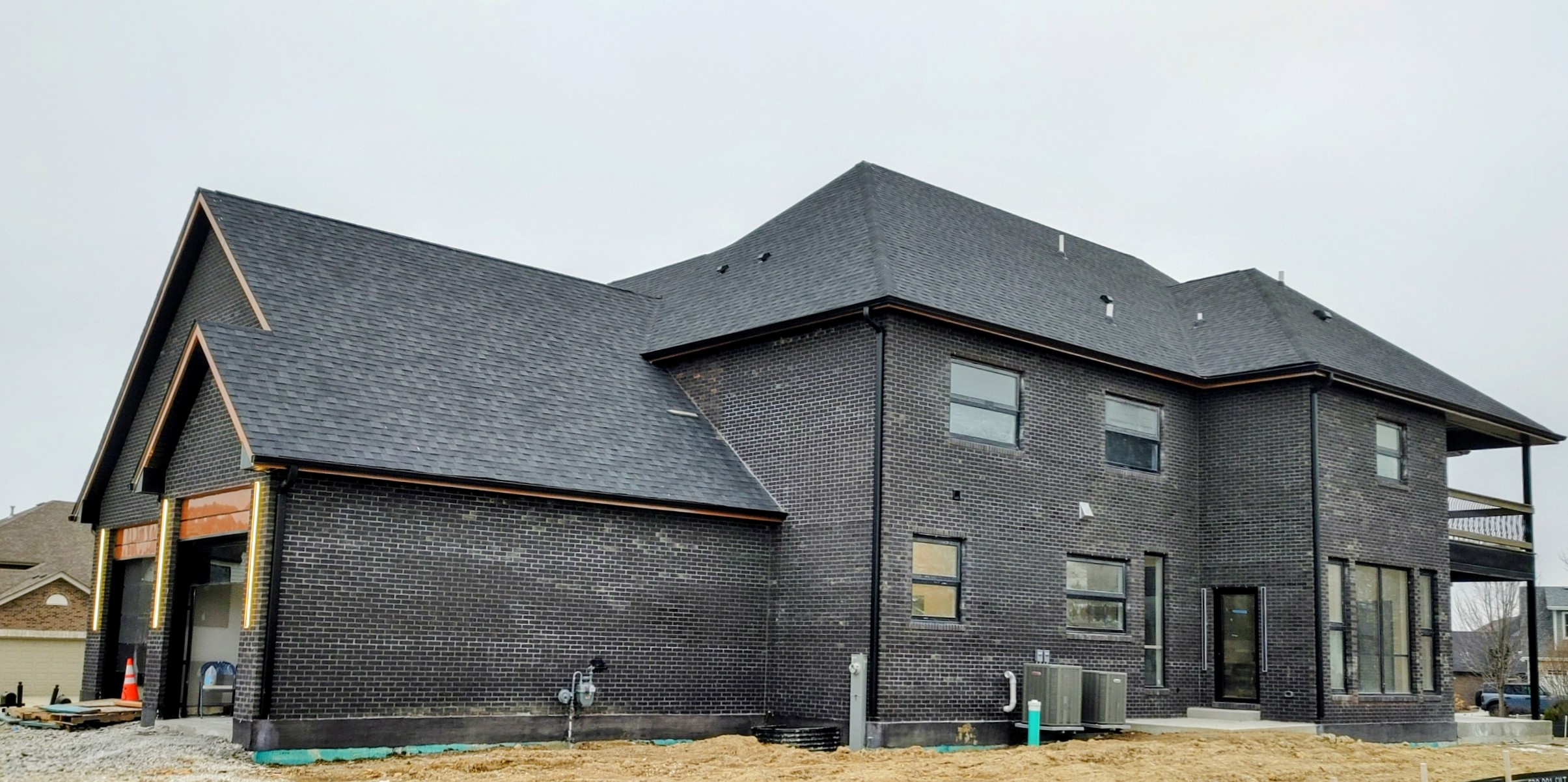

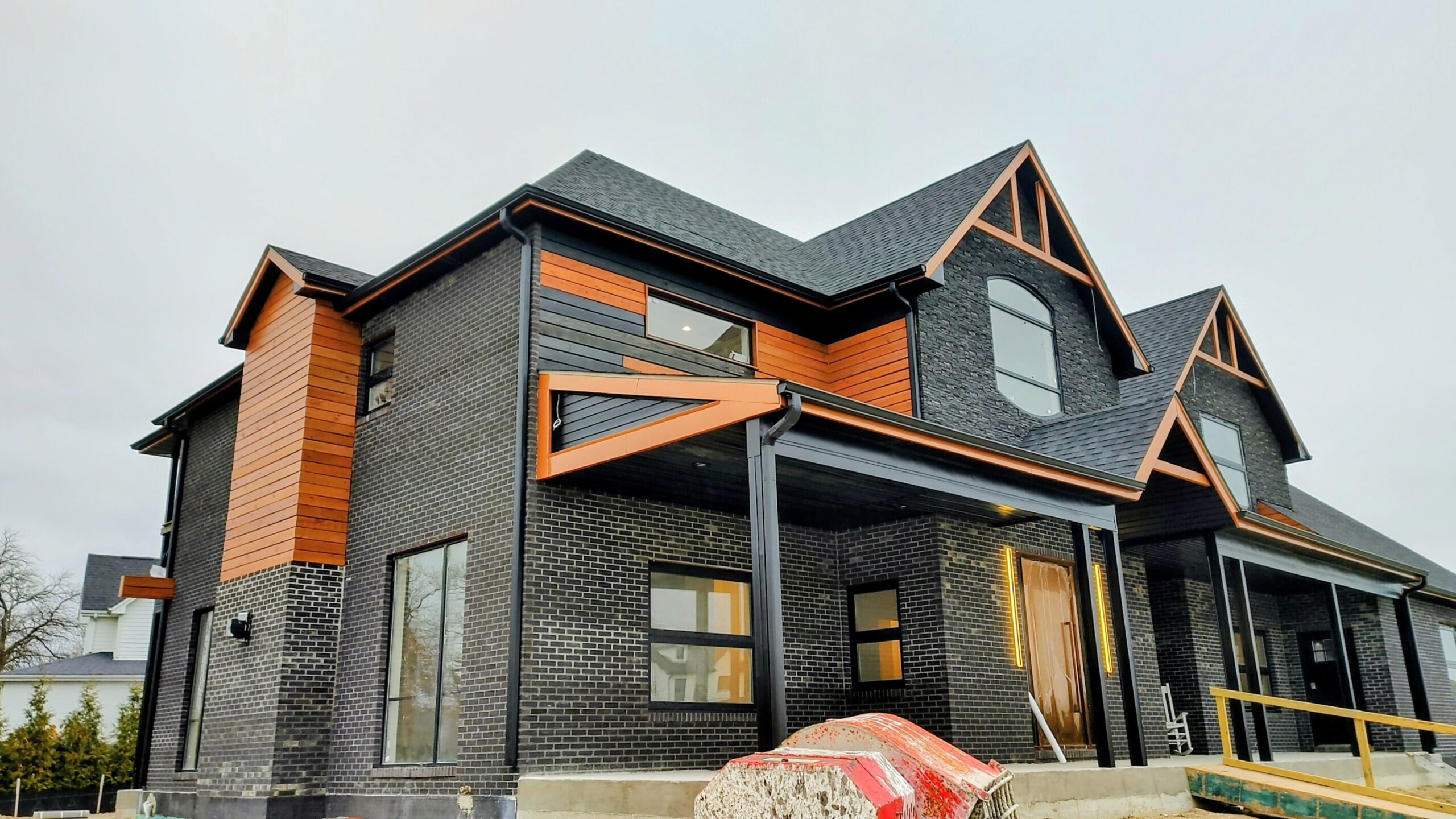

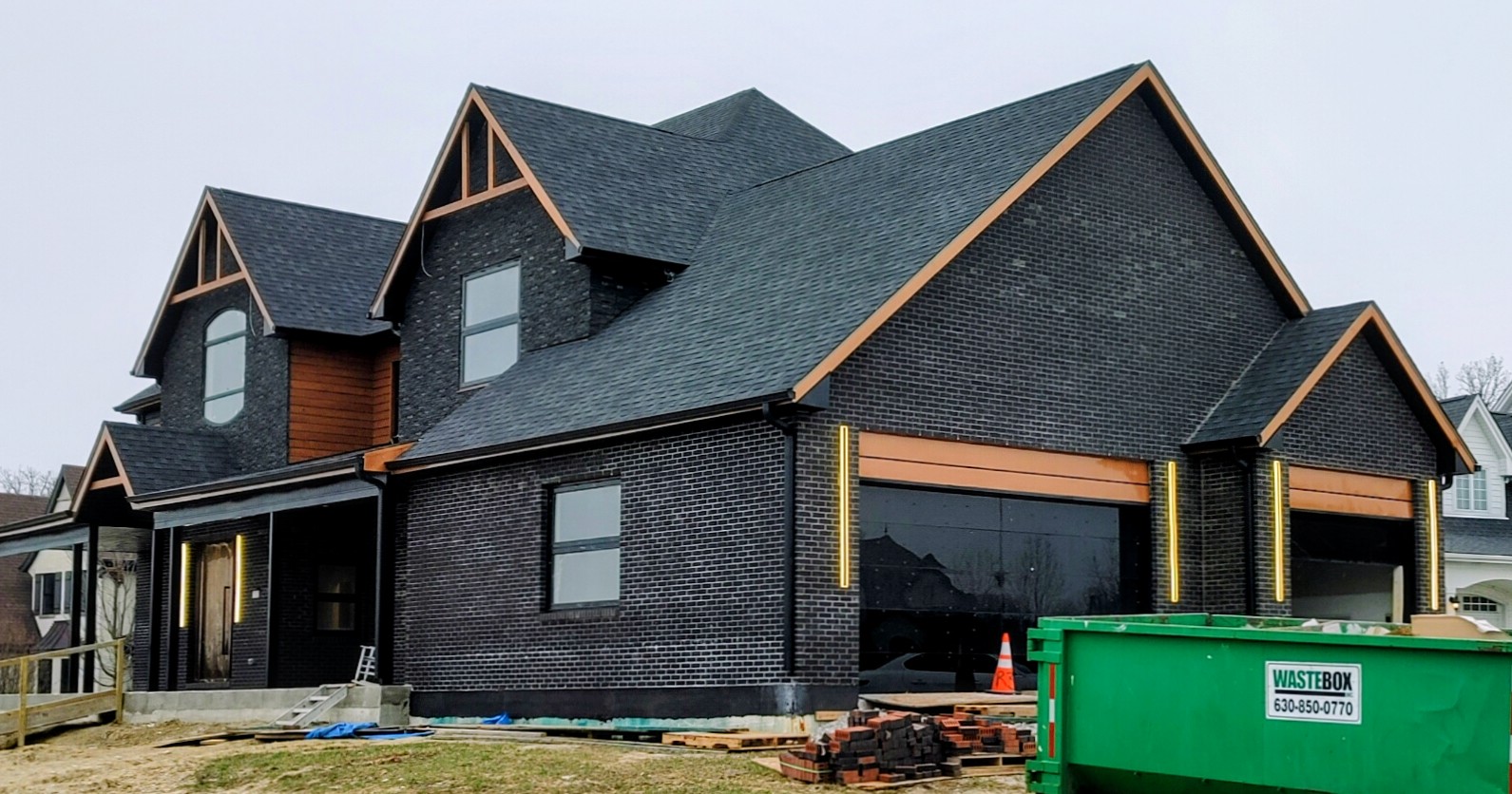

1-25 – 3-10: All Drywall, Paint, Flooring, Cabinets, 4 Showers, 4 Vanities, Final Plumbing Installs, Final Electrical Device Installs, Set Garage Doors, Install Garage Service Door, Clean Up Exterior, Build Semi-Permanent Path From Front Door To Street, All Countertop Installs, Set Water Heater & Close Up Exterior Terminations, Pass All Final Inspections.
